RetrospectivePJM

The Day PJM Broke Its Demand Record

July 2, 2026. Extreme heat pushed preliminary unrestricted demand to 168,158 MW. Demand response, available generation, and federal permit relief helped PJM maintain reliability; separate backup authority for large loads was never activated.

PJM map showing extreme heat across its 13-state footprint during the July 2026 heat wave
The July 2 heat covered the full PJM footprint. The operator measured a 97 F regional average, the hottest in its post-event record. Graphic: PJM July 9 hot-weather review.

On July 2, extreme heat pushed PJM to a preliminary all-time unrestricted peak of 168,158 MW. The system physically served an instantaneous peak of 162,713 MW while PJM deployed demand response, called available generation in constrained areas, and relied on a federal order allowing selected generators to operate beyond normal environmental permit limits. Those measures helped PJM maintain reliability. A separate federal order authorizing backup generation at large loads, including data centers, was available but never activated.

The larger number is an estimate of demand before curtailments, not electricity that flowed through the system at one moment. It stands 2,595 MW above PJM's previous all-time peak benchmark of 165,563 MW, set in 2006. Both July figures remain preliminary.

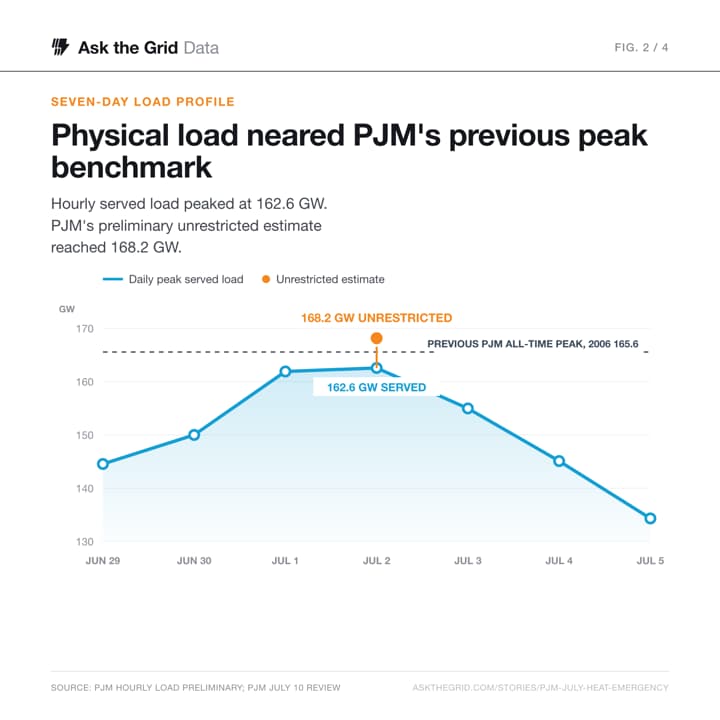

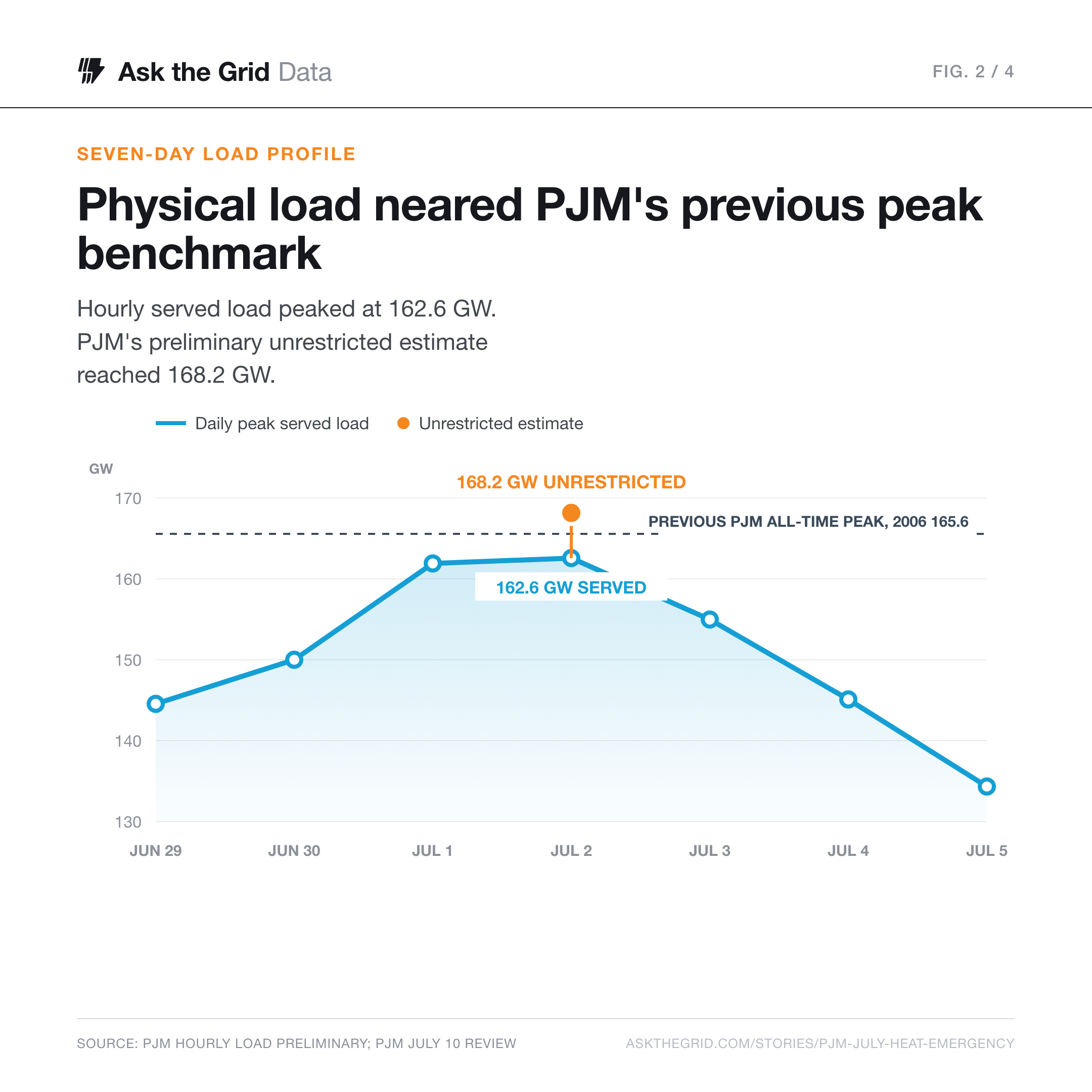

Physical load approached PJM's previous all-time peak benchmark
059.6k119.2k178.8kJun 29Jul 1Jul 3Jul 5Previous PJM all-time peak, 2006Jul 2 peak
Hourly served load(MW)drag to zoom
Two-hour samples of preliminary hourly served load across PJM, June 29 to July 5, with the 5 p.m. peak hour retained (pjm.hrl_load_prelim). The line reaches 162,569 MW; PJM separately reported a preliminary unrestricted peak load of 168,158 MW after accounting for estimated curtailments.

The record is bigger than the meter#

Ask the Grid's hourly series reaches 162,569 MW at 5 p.m., almost exactly matching PJM's 162,713 MW instantaneous reading at 5:55. The difference is measurement: our line is an hourly average assembled from PJM's load areas; PJM's figure is the single highest instant.

Curtailment service providers reported an average of approximately 6,113 MW of expected reductions during the July 2 mandatory availability period. Actual demand-response performance remained preliminary and could take up to three months to finalize.

That figure cannot simply be added to the metered peak. It is an average expectation across hourly-ending periods 11 through 22, while 162,713 MW is an instantaneous reading at 5:55 p.m. and 168,158 MW is PJM's preliminary unrestricted estimate. The three figures describe different measurements of the event.

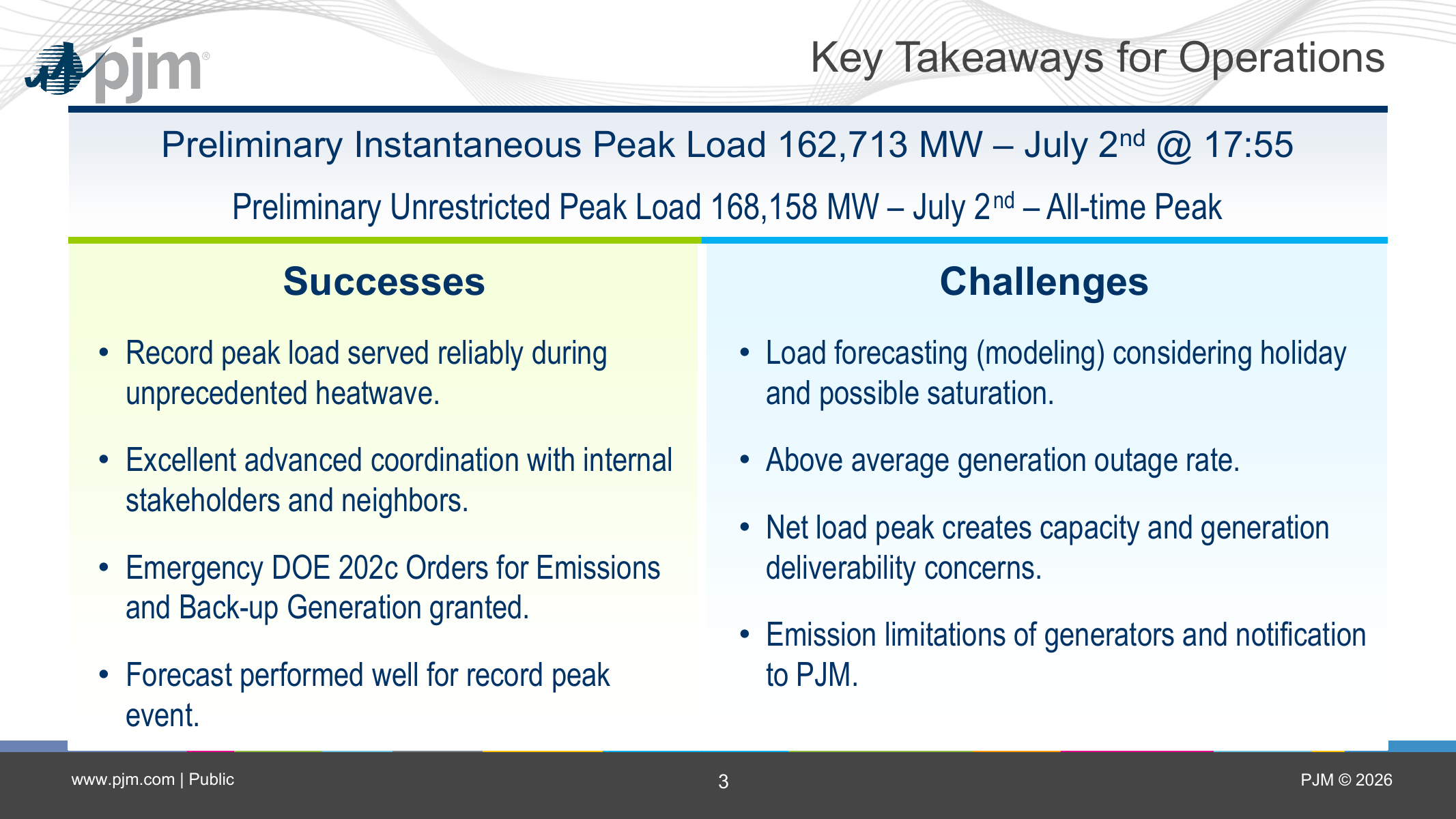

PJM event summary listing record demand, high temperatures, generation outages, expected demand response and permit relief
PJM's preliminary accounting of the July 2-4 event. The 168,158 MW unrestricted peak adds estimated curtailed demand back to physical load. Graphic: PJM.

At 5:18, the emergency stopped being theoretical#

The public operations log lets us rebuild the critical 37 minutes. At 5:18 p.m., PJM declared a Maximum Generation Emergency Action for the Mid-Atlantic and Southern regions. Every available online unit was to move toward emergency maximum output.

At 5:32 p.m., PJM issued an Emergency Use of Back-Up Generator Warning. Large loads in the two regions were being told to prepare for the possibility that they would have 15 minutes to disconnect from utility power and move onto their own generators.

At 5:36 p.m., it issued a Deploy All Resources Action specifically for BGE, PEPCO and Dominion. Generators were ordered to full output, offline generation was to start as quickly as possible, and dispatched load-management customers were to reduce consumption immediately. The instantaneous peak arrived 19 minutes later.

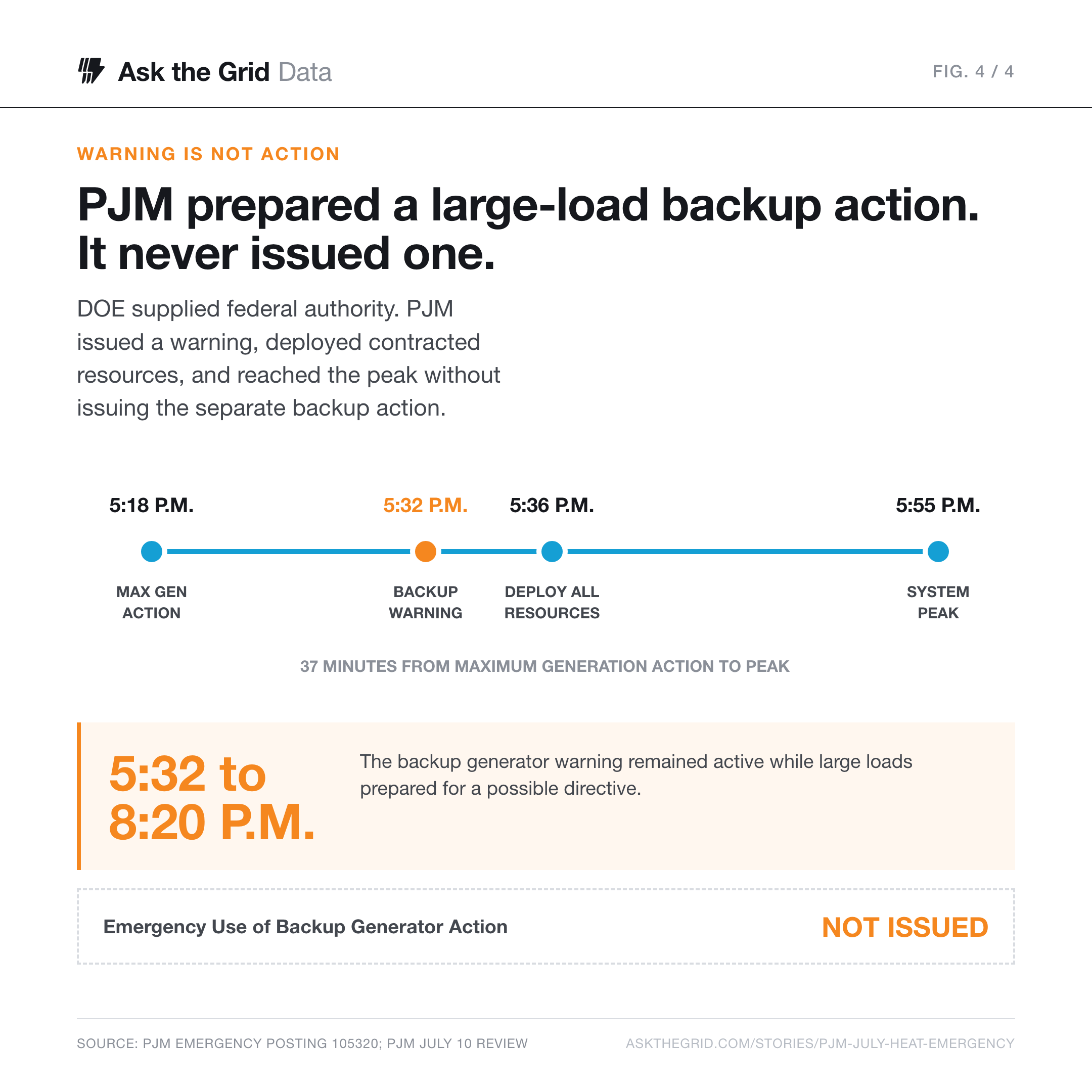

Thirty-seven minutes into the emergency
Time (ET)PJM actionWhat changed
5:18 p.m.Maximum Generation ActionAll available generation called
5:32 p.m.Backup Generator WarningLarge-load backup action prepared, not deployed
5:36 p.m.Deploy All ResourcesBGE, Dominion and PEPCO targeted
5:55 p.m.Estimated instantaneous peak162,713 MW physically served
8:40 p.m.Maximum Generation endedEmergency actions cleared
PJM emergency postings and the operator's July 9 event review. The backup-generator step remained a warning; PJM never issued the separate action that would have directed large loads to transfer to on-site generators.

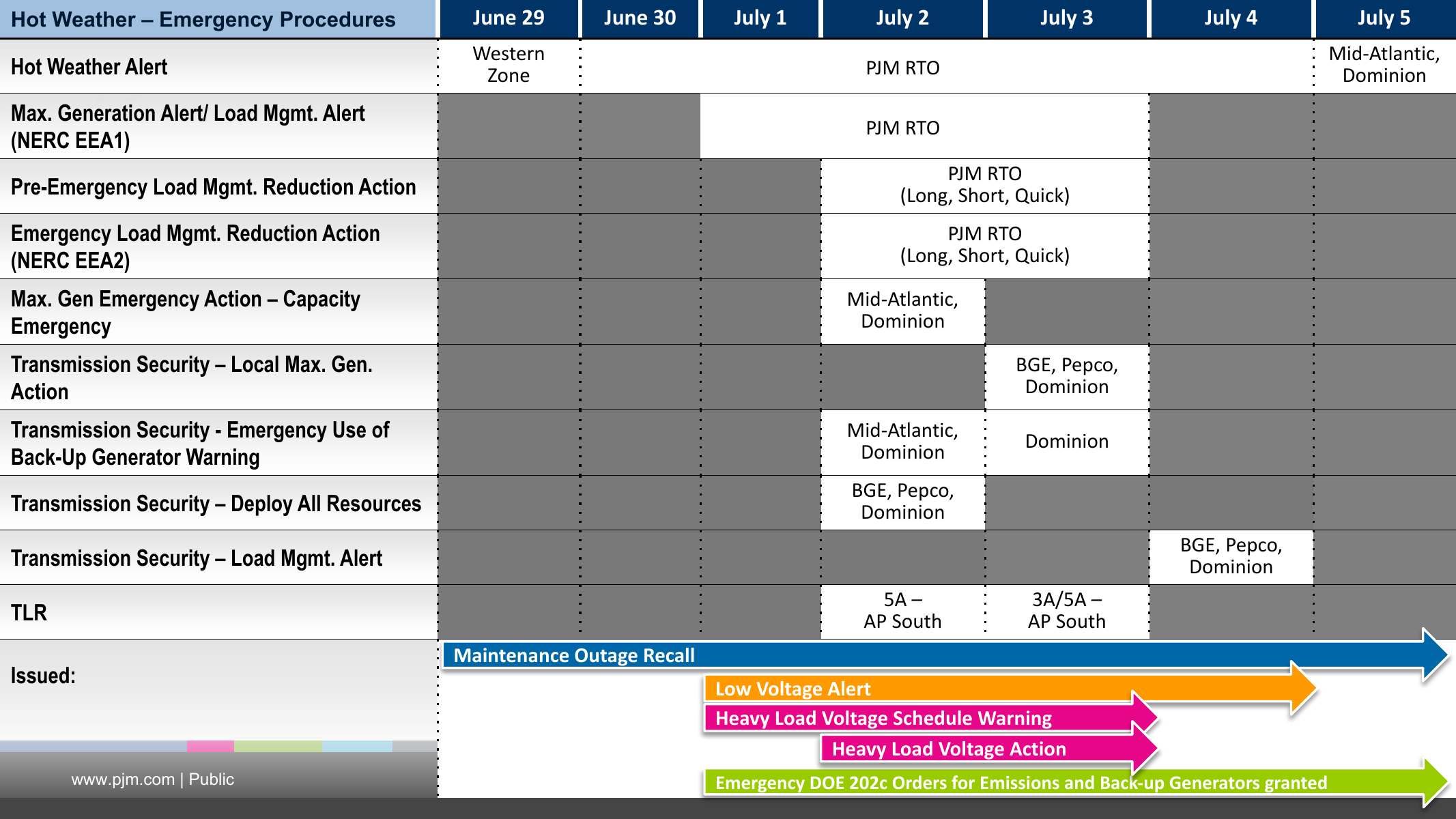

PJM timeline of emergency procedures across July 2, July 3 and July 4
PJM's full emergency-procedure timeline. The July 2 escalation reached Maximum Generation and a backup-generator warning, then cleared that evening. Graphic: PJM.
At 5 p.m., pre-emergency demand response was active. PJM escalated to Maximum Generation Emergency procedures at 5:18 and ordered all available resources in the affected areas deployed at 5:36.
Open on the main map
1/2

The large-load backup action never came#

The word warning is doing crucial work.

Five days earlier, on June 27, PJM had applied for emergency authority to call backup generation at large loads, including data centers and other industrial and commercial facilities. Its application defined large loads as sites with at least 50 MW at each delivery point or point of interconnection. DOE granted the authority on June 30 in Order 202-26-33.

But authority is not activation. PJM's public emergency log contains the 5:32 warning and no Emergency Use of Back-Up Generator Action. PJM's own post-event report is explicit: the action was not needed and was never issued.

The public record therefore does not support the claim that PJM ordered data centers onto diesel generators on July 2. It supports a narrower and more revealing statement: the system got close enough that operators warned large loads to be ready.

The six-gigawatt figure was not yet settled#

This does not mean behind-the-meter generators stayed idle. PJM's separate, market-based demand-response programs were already running. Pre-emergency resources began reducing load at 1:30 p.m. Emergency products followed later, including resources PJM defines as behind-the-meter generators whose permits require an EEA2 condition before they can operate.

The difference is between PJM dispatching registered resources under existing demand-response programs and issuing the federal last-resort action aimed at large loads. The market dispatch happened. The federal action did not. Final measured performance for the market dispatch was still unsettled.

PJM's six-gigawatt figure was an expected reduction
DayCSP-reported expected reductionsMeasurement window
July 26,113 MW averageMandatory availability period, HE11-HE22
July 35,037 MW averageMandatory availability period, HE11-HE22
PJM labels these values CSP-reported expected reductions averaged over the mandatory availability period. They are not settled performance at the instantaneous peak; actual reductions may take up to three months to finalize.

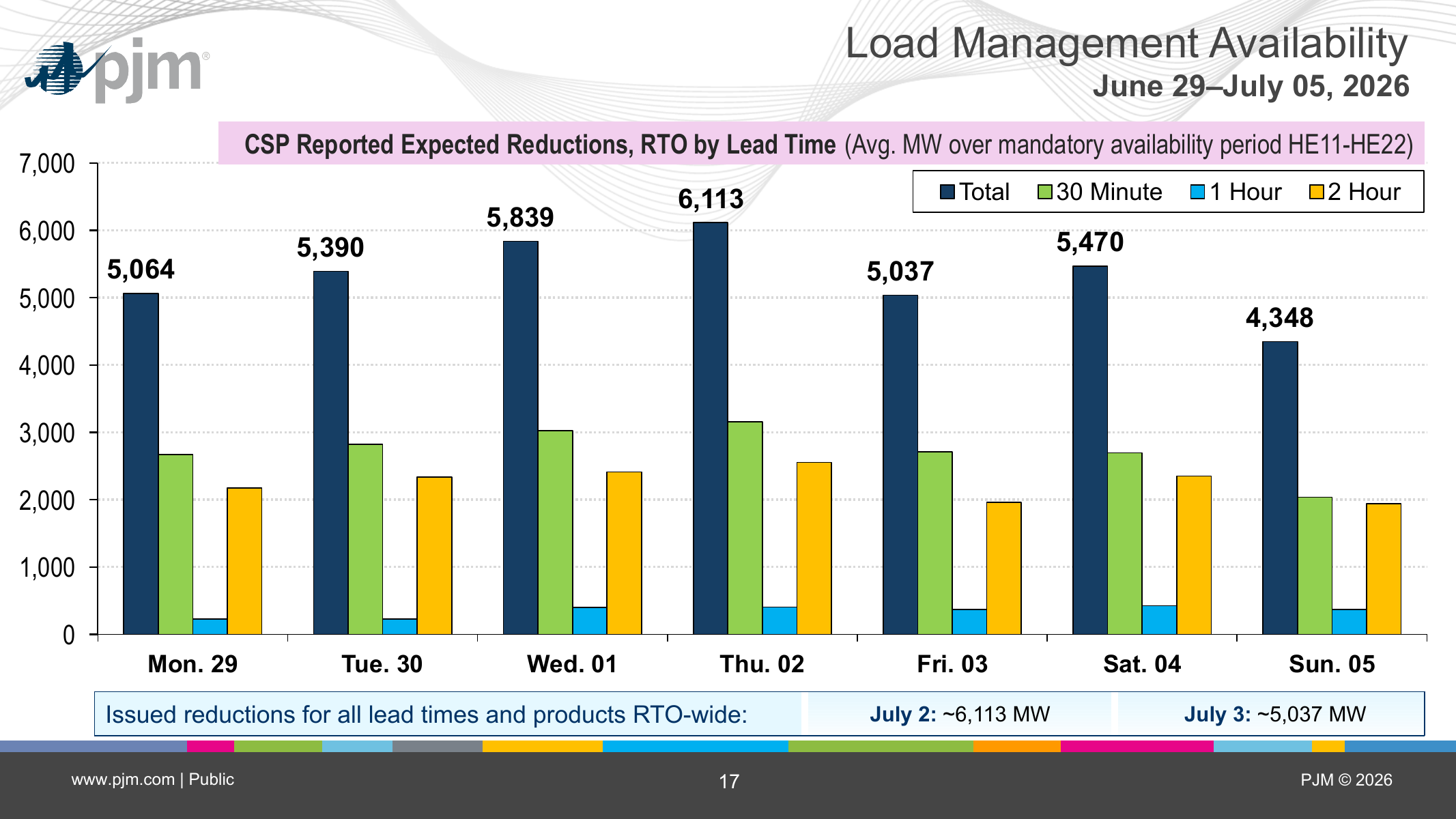

PJM chart of CSP-reported expected demand reductions from June 29 through July 5
Curtailment service providers reported average expected reductions of 6,113 MW on July 2 and 5,037 MW on July 3 during the mandatory availability period. Actual reductions were not yet final. Graphic: PJM.

Public data gives the program-level result, but not the customer list. It does not say which participants were data centers, how many megawatts they curtailed, or which facilities started engines. A data center could have participated as registered demand response without being ordered to do so under the federal authority. PJM does not publish enough detail to separate those cases.

Oil went from spare tire to six-gigawatt resource#

While demand moved down, the generation stack moved up. At the 5 p.m. hourly peak, natural gas supplied 70,435 MW, nuclear plants 31,704 MW, and coal 28,761 MW. Solar was still producing 11,477 MW. The unusual resource was oil.

At 6 a.m. Eastern, oil was supplying 639 MW. Eleven hours later it was producing 6,194 MW, and it reached 6,425 MW at 7 p.m. Oil is expensive and emissions-intensive, and much of this fleet exists for exactly these hours: when the system has exhausted cheaper options.

Gas carried the day; oil supplied the last six gigawatts
026.0k52.0k78.0k12 AM7 AM3 PM11 PMSystem peak
GasNuclearCoalSolarOil(MW)drag to zoom
Hourly PJM generation by fuel on July 2 (pjm.gen_by_fuel). Oil rose from 639 MW at 6 a.m. Eastern to 6,194 MW at the 5 p.m. load peak, then reached 6,425 MW at 7 p.m.
Oil generation stayed elevated through the holiday weekend
02.3k4.7k7.0kJun 29Jul 1Jul 3Jul 5
Daily oil peak(MW)drag to zoom
Daily peak oil-fired output in PJM, June 29 to July 5 (pjm.gen_by_fuel). Oil peaked at 6,519 MW on July 3, the day after the demand record.

The most expensive power was where the grid was tightest#

The stress was not evenly distributed. PJM's deploy-all-resources action named BGE, PEPCO and Dominion, the same Mid-Atlantic corridor where heat, outages and transmission constraints converged.

Day-ahead prices had already anticipated trouble. In BGE, the July 2 hourly price reached $1,598.77/MWh. PEPCO reached $1,533.62/MWh. The PJM-wide reference reached $1,219.91/MWh an hour later. Most days in the preceding week averaged tens of dollars per megawatt-hour at PJM-RTO.

The highest day-ahead prices formed around Baltimore and Washington
05761.2k1.7k12 AM7 AM3 PM11 PM
BGEPEPCOWestern HubPJM-RTODominion Hub($/MWh)drag to zoom
Hourly day-ahead locational marginal prices for July 2 (pjm.da_hrl_lmps). These are wholesale prices, not retail bills. BGE reached $1,598.77/MWh in the 6 p.m. hour; the PJM-wide reference reached $1,219.91/MWh an hour later.

This is evidence of wholesale system stress, not a direct measure of anyone's electric bill. Retail customers buy through utilities, suppliers, hedges and regulated procurement plans. Emergency costs may also be allocated later through uplift. The event created expensive wholesale hours; the public data cannot turn those hours into a universal household bill increase.

Generation outages rose during the heat event#

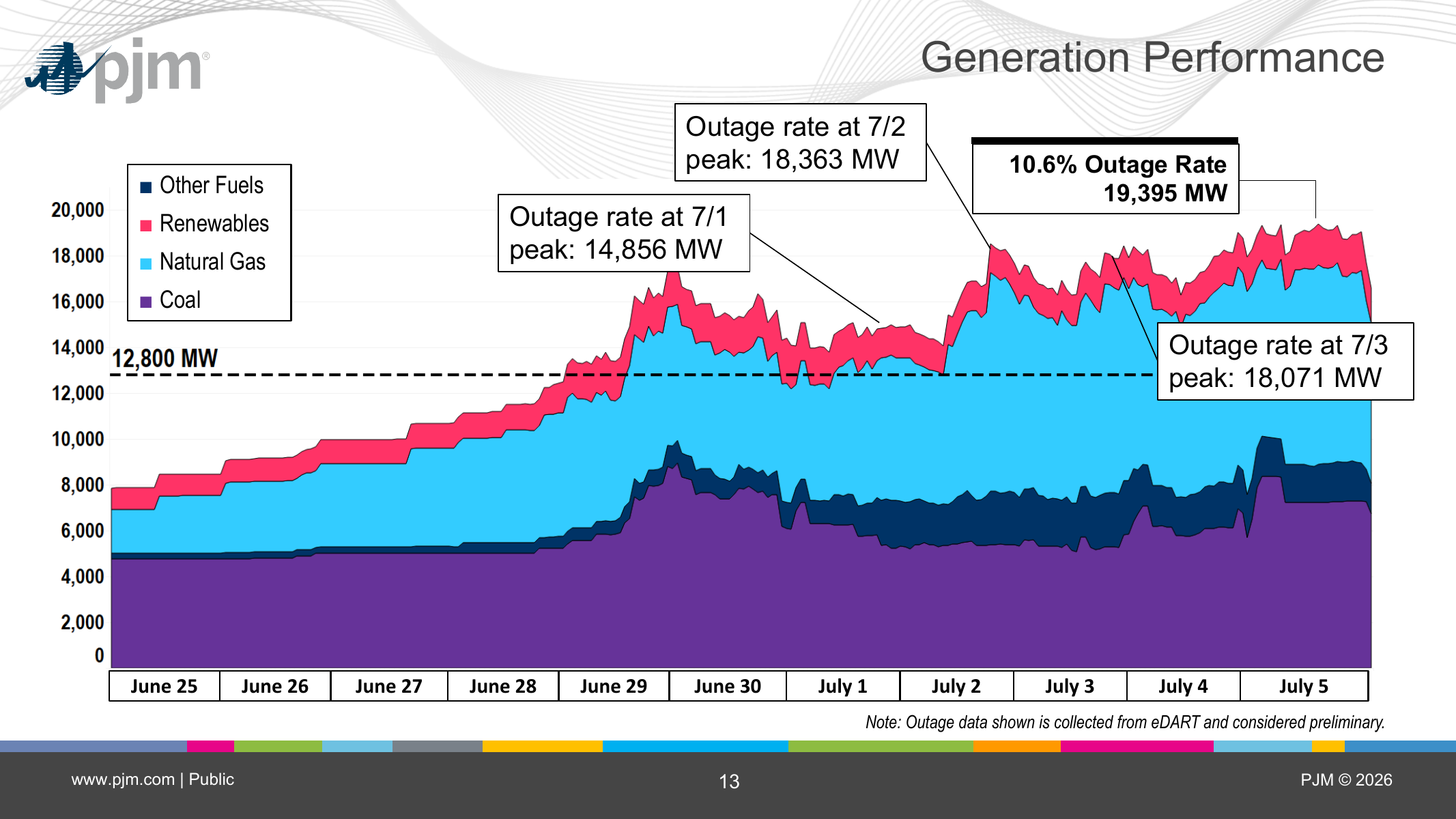

Demand alone did not create the emergency. PJM reported 18,363 MW of generation outages at the July 2 peak and 18,071 MW at the July 3 peak, compared with roughly 12,800 MW on the ten highest summer peak days of the previous three years. Its preliminary event-period chart subsequently reached 19,395 MW around July 5.

Generation outages and derates were elevated during the heat event. Plant-equipment problems accounted for the largest category, while ambient-air limitations and other or unknown causes were also significant.

PJM comparison of generation outages during the July 2026 heat wave with prior summer peak days
Generation outages were elevated during the event. PJM reported 18,363 MW at the July 2 peak, 18,071 MW at the July 3 peak, and a later event-period maximum of 19,395 MW around July 5. Graphic: PJM.

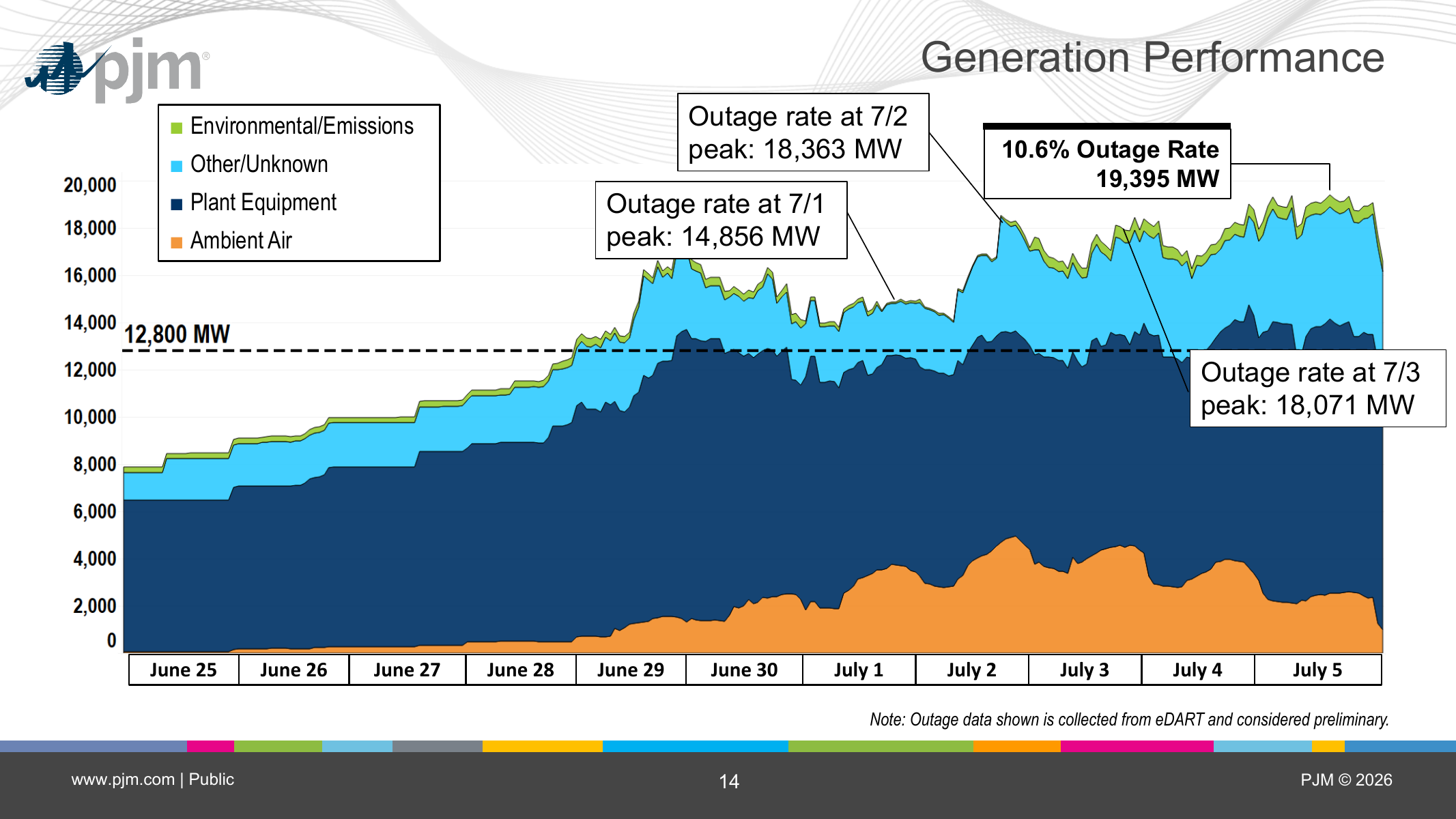

PJM breakdown of generation outage causes during the July 2026 heat wave
Plant-equipment problems were the largest reported outage category. Ambient-air limitations and other or unknown causes were also significant. Graphic: PJM.

Ninety-four generators crossed permit lines#

DOE's other order, 202-26-32, addressed the supply side. It covered 594 units at 51 plants, about 20.4 GW of installed capacity, whose environmental permits or operating restrictions could limit them during the emergency.

PJM now says 94 units at 17 plants, representing approximately 3.25 GW, actually ran beyond permit limits under that authority. Together they accumulated 1,107 unit-hours above those limits.

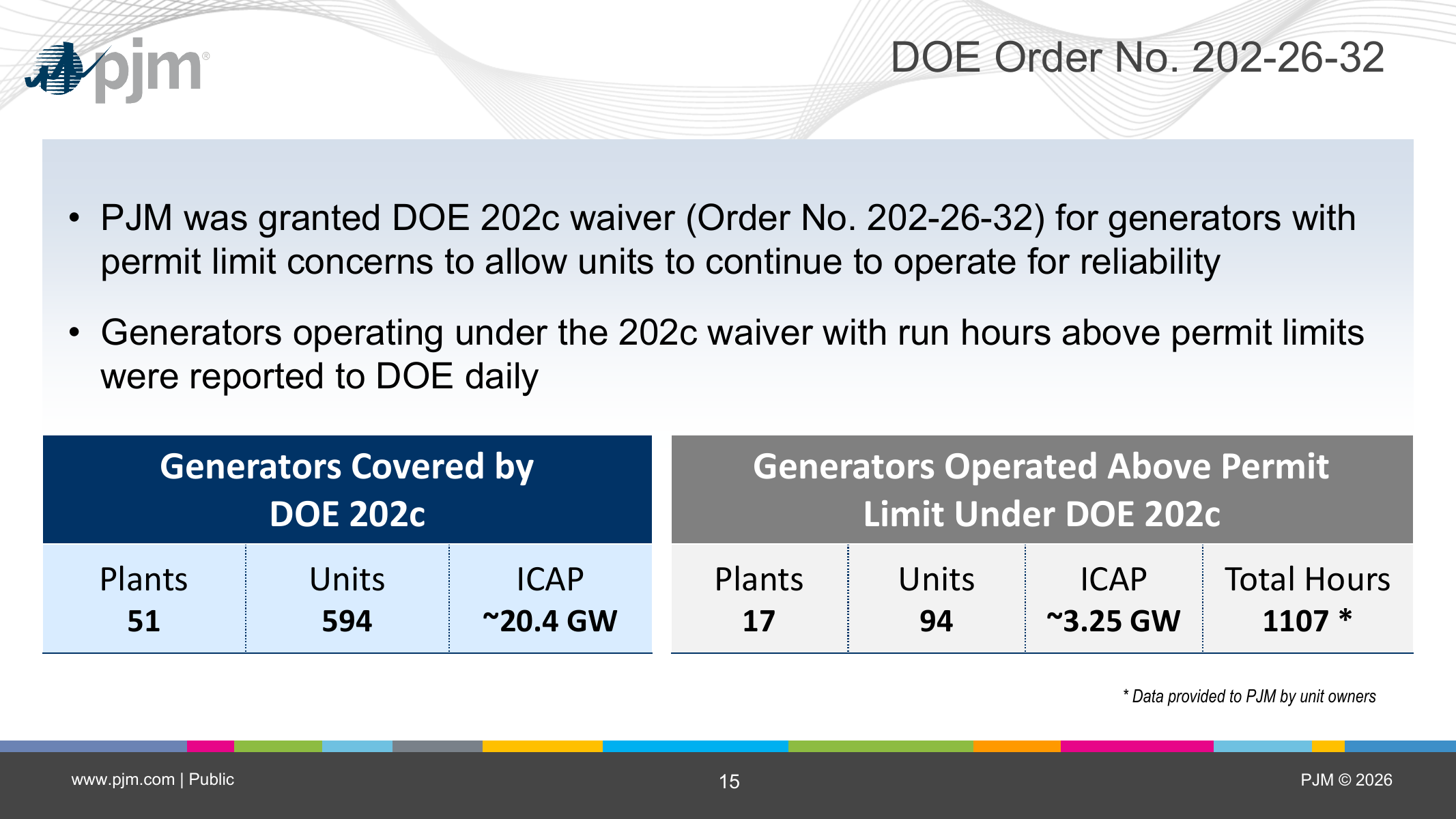

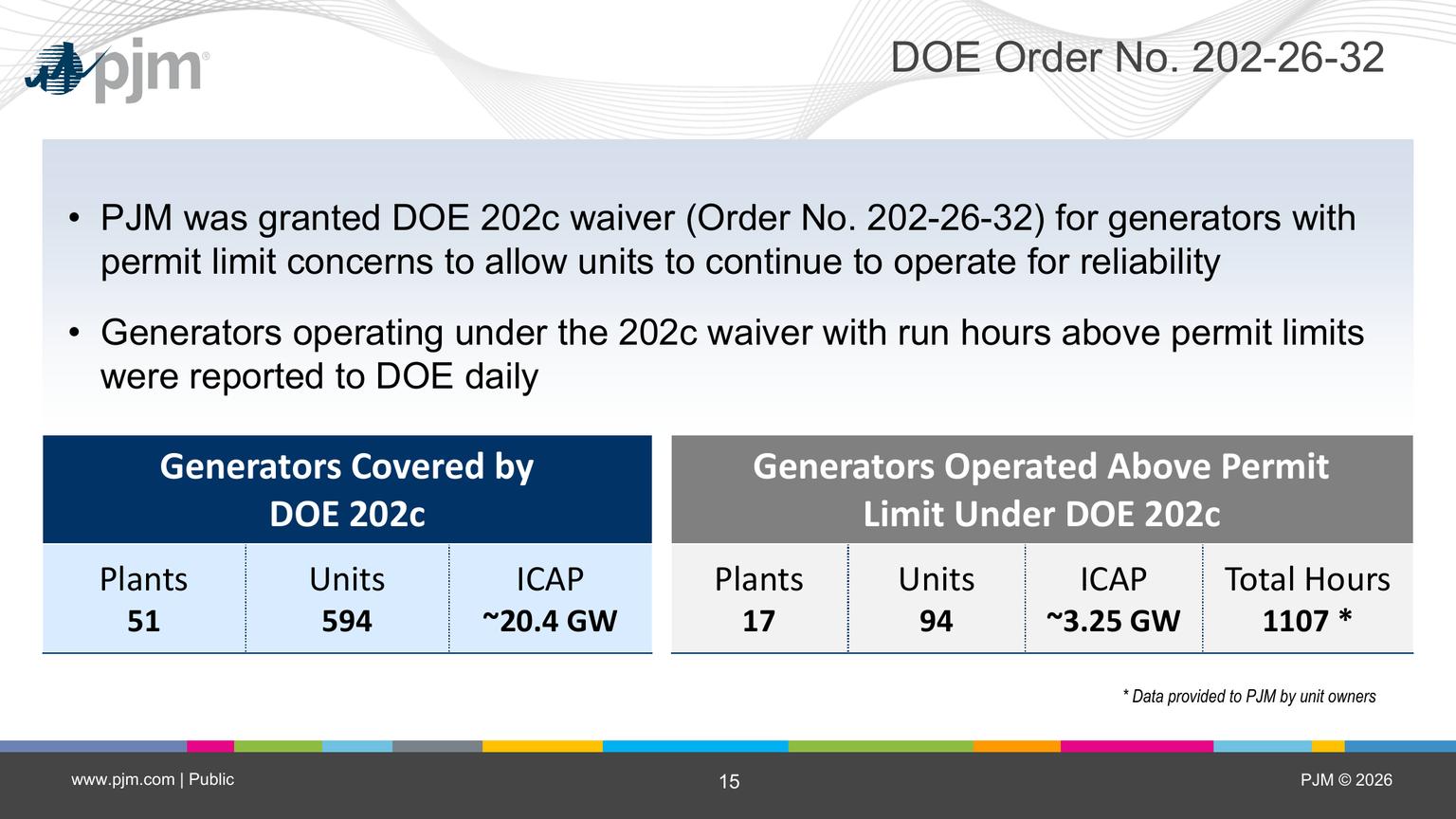

PJM summary of generators operating beyond environmental permit limits during the July 2026 heat wave
The supply-side federal order was used: 94 units at 17 plants reported operating beyond permit limits. Graphic: PJM.
Preliminary AirNow daily ozone AQI
MonitorJuly 2 ozone AQICategory
Edgewood136Unhealthy for sensitive groups
Essex115Unhealthy for sensitive groups
Fair Hill108Unhealthy for sensitive groups
Aldino105Unhealthy for sensitive groups
Southern Maryland101Unhealthy for sensitive groups
Preliminary AirNow daily ozone AQI for July 2. AirNow data undergo preliminary quality checks but are not fully validated for regulatory use. These readings establish air-quality conditions, not causation, and cannot isolate the effect of PJM's temporary generator permit relief.

That is an unusually concrete environmental finding. It is also the boundary of the public record. PJM says unit owners reported waiver-dependent operations daily, but the unit-level notices are not posted alongside DOE's order. DOE publishes changing lists of eligible units; those lists are not proof that every listed plant ran or exceeded a permit.

AirNow monitors recorded unhealthy-for-sensitive-groups ozone in parts of Maryland on July 2, including AQI 136 at Edgewood. Those readings cannot attribute a monitor result to the federal waiver. Heat and sunlight drive ozone formation, and power plants are only one source among several. The supportable conclusion is that plants operated beyond permit limits. The unsupported one is that the order caused a particular community's bad-air day.

Data centers are part of the load, not a smoking gun#

Data centers are not incidental to PJM's load forecast. PJM's May forecast-accuracy report puts the 2026 data-center July peak at 11,479 MW. That is equivalent to 6.8 percent of a peak the size of 168,158 MW.

PJM's data-center forecast is large, but it is not an event meter
AreaShare of 2026 forecast at July peak
Dominion61.6%
AEP23.5%
ComEd7.7%
PS2.7%
Other zones4.4%
PJM forecast total11,479 MW
PJM 2026 Load Forecast Accuracy Report. Zone shares are PJM's published rounded values; they sum to 99.9% because of rounding. The report does not publish site-level, event-hour data-center load sufficient to assign the emergency to specific campuses or companies.

The forecast is geographically concentrated. PJM assigns 61.6 percent of the 2026 data-center July peak to Dominion and 23.5 percent to AEP. ComEd accounts for 7.7 percent and PS for 2.7 percent. Those are PJM's published rounded zone shares, not event-hour meter readings.

But a structural driver is not the same as an event trigger. PJM does not publish actual data-center demand for 5:55 p.m. on July 2. It does not publish a site-by-site curtailment list. It does not identify operators or owners within the 6,113 MW of CSP-reported expected reductions. The forecast can tell us how large the sector has become, not which server hall created the final megawatt of the emergency.

The public record ends before the site gate#

PJM got through the hottest regional day it has measured without voltage reduction, manual load shed, or the special backup-generator action. It deployed load management, ordered all available resources in affected areas, and used supply-side federal authority that allowed 94 units to operate beyond permit limits. Those measures helped PJM maintain reliability.

The affected areas included Dominion, which contains PJM's largest concentration of forecast data-center load, alongside BGE and PEPCO. PJM attributed the regional constraint to interface and reactive-transfer limits; the published evidence does not establish that data centers caused it.

That is more consequential than saying data centers caused an emergency. It shows exactly how close the system came, exactly which levers operators pulled, and exactly where public transparency stopped.

We know the grid warned large loads. We know PJM dispatched pre-emergency and emergency demand-response products, including a product class that can contain registered behind-the-meter generators. We know 17 plants exceeded permit limits. We know PJM's forecast data-center peak is almost 7 percent of a system peak this size.

We still do not know which data centers reduced load, which ones started generators, or what they emitted. For a resource PJM may increasingly depend on during emergencies, that is not a small missing field. It is the next story.

The charts above are frozen from the PJM data behind Ask the Grid at publication. Open PJM on the main map and replay July 2, 2026.
